A Dream of Project Management

Share
Reading time ~3 minutes

A short post today…

A lesson in seeing the wood for the trees

Last week I had a dream about project management – sad, I know!

I was in a room with 3 other people. The first posed a problem…

“You’re starting a new software company and have decided you want to kit out your new 3 storey office properly. For the sake of simplicity, the 2 key tasks that need completing are decorating and wiring. The wiring cannot start until the decorating is complete. You want to be moved in in a month however decorating takes a week per floor and wiring takes 3 days per floor. Can you do it?”

A project manager stepped up and started talking through the problem

“It’s a simple, sequencing and crashing problem.”

“We can do one floor at a time. A week of decorating and then a week of wiring for each floor.”

“By the end of the month, you’ll have 2 floors ready which should be plenty.”

“If you need to run faster, we could contract in some more resources, run each floor in parallel.”

“There’s still drying time to take into account so each cycle of decorating won’t be able to run any quicker but in theory with enough resources and adding in contingency and risk, I think we could commit to being moved in in 3 weeks.”

The “dream me” smugly stepped up and said

“That could work but where are you going to get all the extra people from and can you afford it.”

“Can’t you see, it’s a theory of constraints problem. For the first week, the wiring team are unoccupied. Let’s have them step in and help the decorators. And when that’s done, let’s have the decorating team help with the wiring.”

“We can have one floor ready in much less than 2 weeks and have them all done within 5”

Obviously the “dream me” had failed to notice that electricians and decorators are different skill sets. And still mentally treated them as “fungible resources”. (Nobody would ever think something like that in the software development world right?!)

Then the “Systems Thinker” stepped up and said.

“You’re starting a new software company in the 21st century…”

“…Why the hell do you need an office at all!”

If you’ve not been watching HBO’s “Silicon Valley” comedy series; I thoroughly recommend it. It’s offensive but is a powerful series of caricatured observations of the software industry. Season 3 includes an episode where a promising startup blows nearly all their funding on plush offices, chefs, a foosball table and all the other trendy office quirks.

So the dream was over-simplistic and flawed in many ways but it did at least encourage me to start writing again.

Don’t just focus on the problem or solution immediately in front of you. When somebody presents you with the solution they want, remember to take some time to figure out what they actually need to achieve and discuss their rationale and motivations.

All too often we want to step in, help, achieve, and deliver.

Stop and think about the context, goals, impacts, and relative value/opportunity trade-offs before starting on that next great solution.

Seeing the Value in Task Estimates

Share
Reading time ~5 minutes

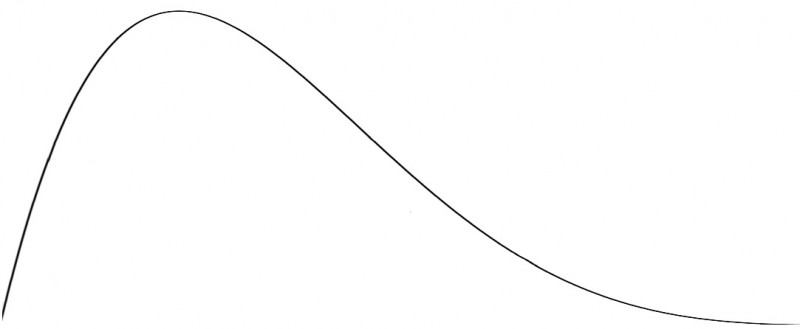

a list of task estimate sizes with beta curves overlaidYou might be aware of the ongoing discussions around the #noEstimates movement right now. I have the luxury here of rarely needing to use estimates as commitments to management but I usually (not always) still ask my teams to estimate their tasks.

My consistently positive experiences so far mean I’m unlikely to stop any time soon.

3 weeks ago I joined a new team. I decided I wanted to get back into the commercial side of the business for a while so I’ve joined our Sales Operations team. (Think DevOps but for sales admin, systems, reporting, targeting & metrics).

Fortunately for me the current manager of the team who took the role on a month or so earlier is amazing. She has so much sales domain knowledge, an instinct for what’s going on and deeply understands what’s needed by our customers (the sales teams).

I’d been working with her informally for a while getting her up to speed on agile project management so by the time I joined the team already had a basic whiteboard in place, were having effective daily standups and were tracking tasks.

The big problem with an ops team is balancing strategic and tactical work. Right now the work is all tactical, urgent items come in daily at the cost of important but less urgent work.

We’re also facing capacity issues with the team and much of the work is all flowing to a single domain expert who’s due to go on leave for a few months this Summer – again a common problem in ops teams.

I observed the movement of tasks on the team board for a week to understand how things were running, spot what was flowing well and what was blocked. As I observed I noted challenges being faced and possible improvements to make. By the end of the week I started implementing a series of near-daily changes – My approach was very similar to that taken in “a year of whiteboard evolution“.

Since the start of April we’ve made 17 “tweaks” to the way the team works and have a backlog of nearly 30 more.

Last week we started adding estimates to tasks.

I trained the team on task estimation – it took less than 10 minutes to explain after one of our standups. The technical details on how I teach this are in my post on story points. But there’s more than just the technical aspect. (In fact the technicalities are secondary to be honest)

Here’s the human side of task estimation…

  • Tasks are estimated in what I describe as “day fragments” – essentially an effort hours equivalent of story points. These are periods of time “small enough to fit in your head”.
  • The distribution scale for task estimates I recommend is always the same. 0.5, 1, 2, 4, 8, 16, 24 hours. (the last 3 are 1, 2 and 3 days) – It’s rare to see a task with a “24” on it. This offers the same kind of declining precision we see with Fibonacci-based story point estimates.
  • For the level of accuracy & precision we’re after I recommend spending less than 30 seconds to provide an estimate for any task. (Usually more like 5-10)
  • If you can’t provide an estimate then you’re missing a task somewhere on understanding what’s needed.
  • Any task of size 8 or more is probably more than one task.
  • Simply having an estimate on a task makes it easier to start work on – especially if the estimate is small (this is one of the tactics in the Cracking Big Rocks card deck)
  • By having an estimate, you have a better idea of when you’ll be done based on other commitments and activities, this means you can manage expectations better.
  • The estimates don’t need to be accurate but the more often you estimate, the better you get at it.
  • When a task is “done”, we re-check the estimate but we only change the number if the result is wildly off. E.g. if a 1 day task takes just an hour or vice versa. And we only do this to learn, understand and improve, not to worry or blame.

So why is this worth doing?

Within a day we were already seeing improvements to our flow of work and after a week we had results to show for it.

  • The majority of tasks fell into the 0.5 or 1 hour buckets – a sign of lots of reactive small items.
  • Tasks with estimates of 8 hours or more (1 day’s effort) were consistently “stuck”.
  • We spotted many small tasks jumping the queue ahead of larger more important items despite not being urgent. (Because they were easier to deliver and well-understood)
  • Vague tasks that had been hanging around for weeks were pulled off of the board and replaced with a series more concrete smaller actions. (I didn’t even have to do any prompting)
  • Tasks that still couldn’t be estimated spawned 0.5 or 1 hour tasks to figure out what needed to be done.
  • Large blocked items started moving again.
  • Team members were more confident in what could be achieved and when.
  • We can start capacity planning and gathering data for defining service level agreements and planning more strategic work.

I’m not saying you have to estimate tasks but I strongly believe in the benefits they provide internally to a team.

If you’re not doing so already, try a little simple education with your teams and then run an experiment for a while. You can always stop if it’s not working for you.





A quick update – Janne Sinivirta pointed out that “none of the benefits seem to be from estimates, rather about task breakdown and understanding the tasks.”

He’s got a good point. This is a key thing for me about task estimation. It highlights quickly what you do & don’t understand. The value is at least partially in estimating, not estimates. (Much like the act of planning vs following a plan). Although by adding the estimates to tasks on the wall we could quickly see patterns in flow of tasks that were less clear before and act sooner.

As we move from tactical to strategic work I expect we’ll still need those numbers to help inform how much of our time we need to spend on reactive work. (In most teams I’ve worked in it’s historically about 20% but it’s looking like much more than that here so far).

Martin Burns also highlighted that understanding and breaking down tasks is where much of the work lies. The equivalent of that in this team is in recognising what needs investigation and discussion with users and what doesn’t and adding tasks for those items.

On Story Points and Distributions

Share
Reading time ~6 minutes

If you’ve been reading my posts for a long while, you might remember this curve in relation to fixing bugs. Today I’m resurrecting it for other reasons.right-skewed beta distribution First of all I’ll admit I used to be a bit of an estimation geek. I loved the subject. (really!)

Last summer I attended my first ever #noEstimates session at Agile 2014. What I heard made complete sense to me and there are a few teams here that have stopped estimating (they still measure and forecast throughput) but I still see value in trying to estimate. I’ve seen enough examples over the last decade where work is traded out because a team cannot estimate the effort of the previous.

I love Arlo Belshee’s concept of Naked Planning – in that if you remove all estimation information and focus purely on what the most valuable and important thing is, you’ll do the most valuable and important thing.

The trouble is, in many commercial product situations, it’s not actually that clear what the most valuable thing really is – and value generally has a trade-off of cost. (Or at least “how much am I willing to spend on this”).

I also like Chris Matt’s Options thinking alternative to estimates – “How much are you willing to spend to get a better understanding of this”. This ties in with a fundamental part of estimation theory in that there is a trade-off (and decreasing value) in spending additional time understanding a problem in order to better estimate the outcome.

Finally, whilst many teams I’ve worked with have used story point estimates for stories and hour estimates for tasks, we don’t go in blind. We have triangulation and reference points from prior work wherever possible.

I used to run half-day training courses on software estimation (and still see that course as valuable – primarily because the theory is transferrable). These days, if I have a team that have never had a real conversation about what estimates are, why do them and how I trim down that half-day content into about 15-30 minutes on the most important bits for story and task estimation.

I’ve been using the same explanations on estimation for about 7 years now and although some of my assertions on why we estimate are finally wavering, the information on how is still useful – and – as far as I know, nobody else has explained it this way.

Back in 2011 I wrote an article on Swimlane Sizing that was subsequently referenced and made popular by Alexey Krivitsky in his Scrum Simulation With Lego Bricks paper.

What I want to share today is how all this hangs together based on a very simple concept from the 1950’s.

The PERT technique came from the Polaris missile project and in my very simple terms is essentially a collection of tools and techniques based around probability distribution.

When examining the probability of completing any task there’s a great rule of thumb to start with:

There’s a limit to how well things can go but no limit to how bad they could get!

With this thinking in mind, essentially the completion time and/or effort for a given task can be represented by a probability distribution. A right-skewed beta distribution.

Furthermore, when adding a series of these together, you have a collection of averages. (cue a #noEstimates discussion).

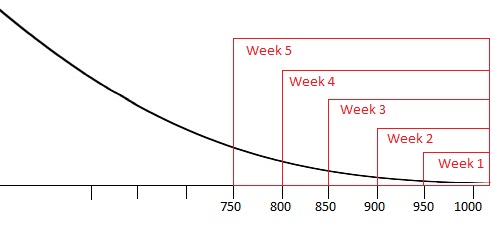

If you ask someone to estimate how long a bug will take to fix, without historic data you’ll get a “how long is a piece of string” type answer. Everyone remembers the big statistical outliers but if you strip these away, you can forecast quite accurately with about 95% confidence. (This is one of the foundations behind using data for service level agreements in Kanban).

Some items will take longer than average, some will be faster but based on those averages, you can get a “good enough” idea on durations.

With PERT, this beta distribution is simplified further to 3 points – “optimistic”, “most likely” and “pessimistic”. The math is simple but at least for today’s point, not important.

Here’s the bits I care about.

PERT summary

Now here’s a neat thing (and the point of this post).

With the introduction of story points, we’ve moved away from the amazing power of  3-point range estimation back to single points.

Once you’re in the realm of single point estimates, people start seeing a falsely implied precision. Unless you’ve actually had training on use of story points (many senior managers probably won’t have done) then you’ll start building all those same human inferences that used to occur with estimates like “It’ll take about 2 weeks”.

When we hear “2 weeks”, we leap to a precise assumption and start making commitments based on that. In range estimation we’d say It’ll take 1 to 4 weeks and in PERT we’d say, “Optimistically it’ll take a week, most likely 2 and pessimistically, 4. Therefore we’ll plan on 2 but offer a contingency of up to a further 2 weeks.”

(Of course in reality, wishful hearing means you might still end up with a 1 or 2 week commitment but hopefully the theory is making sense).



It’s also worth examining the size of the gaps between optimistic -> most likely and most-likely -> pessimistic (in particular, the latter of these 2). These offer a powerful window into the relative levels of risk and uncertainty.

By moving back to single point estimates – at least at the single story level, this starts feeling a lot like precise and accurate commitments**. Our knee-jerk reaction may then be to avoid providing estimates again.

But here’s the missing link…

Every story point estimate is in fact a REPRESENTATION of a range estimate!

We can take this thinking even further…

The greater a story point estimate, the less precise it is.

Obvious right? Let’s take one more step…

 If a story point estimate is a representation of a range then a larger number implies a WIDER range.

Let’s take that back to the swimlane sizing diagram and (crudely) overlay some beta distributions…

swimlane-distributions

Look carefully at how those ranges fall.

  • Some 2 point stories take as long as a 3 point story.
  • Some 5 point stories may be the size of 3 point stories, in rare cases, others may end up being 13 or even 20 points.
  • And some 13 point stories may go off the scale.

And that’s all entirely acceptable!

On average a 5-point story will take X amount of effort.

That’s enough to forecast and that’s enough to start building commitments and service level agreements around (should you need to).

So…

Time to start thinking about what distributions your story point estimates are.

If you’re getting wild variation, how might you capture some useful (but lightweight) data to help you, your team and your management understand and improve?

You might be in a fortunate place where you simply don’t need to produce estimates at all. That’s great. I’d assert there’s a lot to learn by simply trying to estimate even if you don’t use the results for anything but for the majority of us that need to do at least some sane forecasting, this thinking might just make estimation a bit safer and a bit more scientific again.

If you’re interested in more on this, take a look at the human side of estimation in “Seeing the Value in Task Estimates”.

**As an aside, a while ago, the SCRUM guide was updated and replaced “commitment” with “forecast”. That’s a big change and tricky to retrain into those that saw SCRUM as the answer to their predictability problems. (Many managers needed guarantees!) For those of you facing continuing problems here, it’s worth gathering and reviewing story data so you can build service level agreements with known levels of confidence as an alternative.

Iteration Planning With The Captain

Share
Reading time ~1 minutes

Back in 2012 I ran a small workshop at SyncNorwich on iteration planning. It wasn’t one of my best but went down well with the dozen or so participants I had.

During the workshop I asked participants to take a “textbook example” of a sprint planning agenda and adapt it to their own needs. I’ve uploaded the planning worksheet for anyone who fancies experimenting with this for themselves.

If you’re interested, here’s the presentation itself:

Happy new year!



Swimlane Sizing – Complete & Fast Backlog Estimation

Share
Reading time ~5 minutes

Thanks to Adrian Wible for sharing this tip when I was in Nevada a couple of years ago. It’s now one of the most powerful simple tools I have at my disposal. I use it frequently with teams to rapidly size their backlogs and recalibrate their sizing.

This can be used with teams at any experience level but works with least pain if teams aren’t used to story points beforehand.

Teams new to story-points (or even working together) often get hung up on the numbers themselves and instinctively want to start converting to hours, ideal days, elapsed days or similar. The value of story points for teams during estimation sessions is in the relative sizing, not the actual size.

This approach keeps numbers entirely out of the mix until the end and allows participants to focus solely on the relative sizing of stories.

Once we’re over the relative sizing hurdle, adding numbers becomes a straightforward activity.

I’ve done this same activity with electronic tools but I’ll describe the manual version here…

Preparation:

Get your deck of incomplete user stories on readable cards or stickies.

If you also have a couple you have completed, these are useful triangulation points but not mandatory

In a room with your team, get yourself a large flat clear surface. I recommend tabletops in the middle of a space as you can swarm your whole team around all sides – this isn’t so simple with a wall.

Using string or sticky tape mark out 8 “swim-lanes” on the table (Requires 7 lines)

Your table should look something like this.blank table

Don’t put any labels on the swim lanes









Activity:

Divide the deck of stories amongst your team and ask members to spend a maximum of 5 minutes silently placing their stories in the swim lanes – with stories of increasing size from left to right.  E.g. smallest stories in the left-most lane.

You might want to lead the team through the first 1 or 2 random stories to give them some anchors or triangulation points to work from.

Don’t say anything about story points or numbers, if anyone asks just reiterate we’re looking for size relative only to each other.

If needed; guidance on complete unknown stories at this point should be to assume they are “very large”. The next round of sequencing will allow others to move them if they feel confident in doing so.

Once all stories are placed, you’ll probably have some “clumping” of stories, as in the table here. (assume X’s are story cards).

Give the team 5-10 minutes to again silently move any stories to different lanes where they feel their size relative to others makes them more closely aligned to those in another lane (stories must be wholly in a single lane – no overlaps).

Encourage team members to quickly look at and consider the location of each story on the table.

A team may occasionally find a deadlock where a story is “stuck” moving back & forth between lanes, you may intervene, pull the card out for discussion or allow the time boxing to encourage the card into a single location. Generally if there’s uncertainty, I choose the larger option but the last step of the process will resolve these.

Your table should now look something like the example here.

Once all the cards are placed and reviewed, ask the team to rate their satisfaction/confidence on the relative sizing and placement of the cards (use a scale of 1-5). For any team members indicating a low satisfaction level (1 or 2), ask them to describe their concern and for the team to decide upon how to act (either move a card or validate its current position). Time box this to 2 minutes per team member if possible. Use this opportunity to re-place any deadlocked stories – if a team really can’t decide, be cautious and go for the larger option.

Once relative sizing is agreed with a reasonable level of confidence for the whole team it’s time for a couple more questions.

For all the stories in the left-most column, do you think you’ll be working on anything smaller?

If the answer is “yes”, call this column 3 or 5; if the answer is “no”, call this column 1 or 2 (a single number from these options – use your judgement and instinct).

Now assign remaining numbers across the top of the columns using a subset of the common modified Fibonacci sequence used for story point estimation: (0, 0.5, 1, 2, 3, 5, 8, 13, 20, 40, 100, !/?)

This will give you a table of stories much like one of the following…













(I usually prefer the far-right column remains unsized to be broken down further to make it clear that this is a coarse exercise and cannot be used for commitments).

That’s it! You’ve just estimated & sized (using story points) your backlog in well under an hour.

It’s coarse, quick and dirty but chances are that even when you learn more, most of these won’t change relative to those in other columns .

More Depth:

The use of “silent sorting” is a powerful practice for agile teams. It removes debate and ensures focused thinking however in this example its use coupled with the lack of numbers is to avoid a common problem with inexperienced estimation teams during planning poker exercises known as “anchoring”. This is where an individual on a team will speak up with their view on what size a story should be before the remainder of the team have selected their view on size therefore influencing and anchoring all others estimates for the same story to a given point.

If you reuse this approach for additional rounds of backlog items I recommend preserving some of the older stories in the swim lanes to provide triangulation points for newer stories. Without these anchors your team’s velocity and estimation may see large shifts and greater unpredictability based on the shape of the new backlog.

Teams will quickly get used to which numbers match which lanes. This practice is still valuable however you may need to encourage teams to remain focused on relative sizes and not the numbers.

I generally hold the following views (and have found these actually do transfer well across teams)

  • 5 is typically a “medium” sized story for a sprint
  • Anything greater than 8-13 requires further decomposition
  • Seriously consider also decomposing stories of size 8-13
  • Anything greater than 20 is in reality an unknown needing further investigation and decomposition before it can be sized sensibly.

These views can in themselves anchor others’ estimates towards some specific numbers. As a facilitator an awareness of the range of numbers used and their meanings is useful but be cautious that this information does not influence the outcome of the team’s process.

Update: March 2015 – 4 years after posting this article it’s still the second-most viewed page on the site. I’ve now added a second article offering some more theory to help explain how swim lanes and story points hang together with traditional estimation concepts.
